What is MEP Coordination?
How MEP coordination and integration works in a digital model. What is clash detection and how does the MEP coordinator reduce errors on site

The design of modern buildings requires increasingly effective coordination among architectural, structural, and systems disciplines. HVAC systems, electrical networks, plumbing, and fire protection systems share complex technical spaces, where even minor interferences can generate design errors, execution delays, and additional costs.
To manage these critical issues, BIM processes utilize MEP coordination, which refers to the coordination of mechanical, electrical, and plumbing systems within a shared digital model. The goal is to verify the correct integration of different systems, identify any interferences, and resolve them before the construction phase.
Thanks to model coordination and clash detection tools, it is possible to check the systems models more efficiently, optimize the available spaces, and improve collaboration among designers, coordinators, and companies.
Let’s see how MEP coordination works in the BIM environment, what activities are involved, and why it is a fundamental tool for reducing errors and unforeseen issues on site.
Contents
- What is MEP coordination?
- The role of the MEP coordinator in project realization
- How MEP BIM coordination works: from the federated model to interference resolution
- MEP coordination drawings for multidisciplinary control of the model
- Checklist to Avoid Conflicts Between Technological Systems
- Types of clashes in MEP coordination
- How coordinated MEP models reduce errors on the construction site
- Common problems in MEP coordination
- FAQ – MEP coordination
What is MEP coordination?
When we talk about MEP, we are referring to the mechanical, electrical, and plumbing systems of a building, including HVAC systems, electrical distribution, sanitary networks, drainage, fire protection systems, and other technical systems. The acronym MEP stands for Mechanical, Electrical, and Plumbing.
MEP represents a fundamental component of the BIM process: it is estimated that systems can account for up to 40–60% of the total cost of a project. However, BIM and MEP do not indicate the same thing: the former is a method for digital project management, while the latter concerns the design and coordination of the systems. If you want to delve deeper into the differences between the two concepts, you can read this article on BIM and MEP.
In this context, MEP coordination takes on particular importance, which refers to the set of activities aimed at ensuring integration between the different disciplines at all stages of the design, construction, and maintenance process of an asset.
There are 5 steps that generally define the MEP coordination process:
- validation of the architectural model;
- creation of the MEP model;
- federation and use of the BIM MEP model;
- detection of interferences;
- resolution, verification, and validation of interferences.
At the core of interdisciplinary coordination is communication among professionals.
The center of communication is the 3D BIM model, which must always be up-to-date, available, and accurate. Working on a federated model allows for the identification of any interferences and resolving them during the design phase.
For example, at this stage, it may happen that some components of the heating system overlap with the structural mesh hypothesized by the structural engineer. This preliminary check allows for the problem to be resolved in the early stage of the project and avoids costly modifications during the construction phase.
MEP coordination continues through successive cycles of model federation, clash detection, assignment of issues to the relevant teams, review, and verification. The objective is to obtain a coordinated model that is validated and as conflict-free as possible before the production of the execution documents and the start of activities on site.

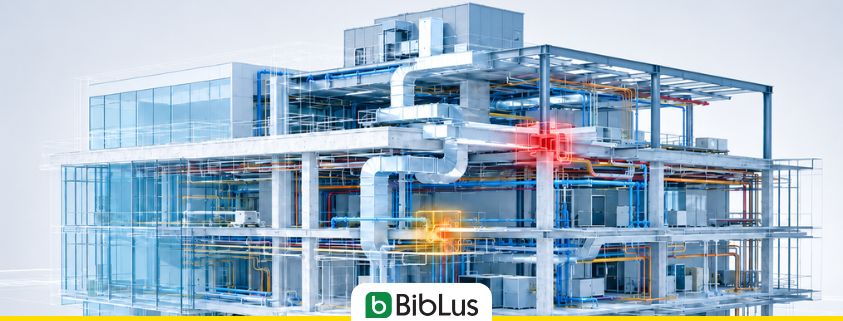

Workflow of the MEP coordination process in the BIM environment
The role of the MEP coordinator in project realization
In the BIM process, the MEP coordinator plays a central role in the management and integration of mechanical, electrical, and plumbing systems within the digital model of the building. Their main task is to ensure that all plant disciplines are correctly coordinated with each other and compatible with the architectural and structural elements of the project.
With the increasing complexity of modern buildings, the coordination of systems has become one of the most delicate activities in the entire design workflow. Ducts, electrical networks, HVAC systems, fire protection systems, and plumbing components share increasingly limited technical spaces. Without effective digital coordination, the risk of interference and execution problems on site increases significantly.
The MEP coordinator thus works as a link figure between designers, BIM managers, BIM coordinators, and executing companies. Through the federated BIM model, they verify the correct integration of the disciplinary models, identify any clashes, and support the team in resolving critical issues before the construction phase.
It is useful to distinguish their role from that of other figures involved in the BIM process: the MEP BIM modeler mainly deals with the informative modeling of the systems; the MEP coordinator coordinates the system models and the resolution of interferences; the BIM coordinator manages the interdisciplinary coordination of the models; the BIM manager defines standards, processes, and informational requirements of the project.
Among the main activities of the MEP coordinator are:
- verification of coherence between the system models;
- control of geometric, spatial, functional, and informational interferences;
- management of model revisions;
- coordination between architectural, structural, and system disciplines;
- support for the production of executive documents;
- verification of spaces for installation and maintenance of systems;
- monitoring compliance with BIM standards and project informational requirements.
To carry out these activities, a deep knowledge of both system design and BIM authoring and coordination tools is essential. In many cases, the MEP coordinator collaborates directly with the MEP BIM modeler, a specialized figure in the informative modeling of systems and the production of disciplinary models.
Another essential aspect concerns the collaborative management of data and models. The MEP coordinator often operates within common data environments (CDE) and uses open formats to favor interoperability between different software. In this context, the correct management of IFC files becomes fundamental to ensure reliable informational exchange among all actors involved in the project.
In more structured workflows, the management of interferences can also occur through formats and procedures for issue management, such as BCF, which allows the sharing of reports, viewpoints, comments, and responsibilities without exchanging the entire model every time.
Thanks to digital coordination, many problems that previously arose directly on site can be identified and resolved in the early design phases. This translates into a reduction of variations, fewer execution delays, and better control of the time and costs of the work.

Coordination between disciplines in the BIM MEP workflow
How MEP BIM coordination works: from the federated model to interference resolution
The MEP coordination process develops through a series of progressive and iterative activities that allow for the control, verification, and optimization of the integration between different systems within the BIM model. The goal is to identify potential issues before the execution phase, reducing the risk of errors, changes during construction, and delays on site.
It all starts with the collection of disciplinary models produced by the various design teams: architectural, structural, and systems. Each discipline develops its own informational model according to specific levels of detail and information requirements and shared modeling rules. The models are then aggregated into a single federated model, which serves as the operational basis for coordination activities.
At this stage, collaboration between the various project stakeholders becomes crucial. Proper BIM coordination and collaboration indeed allows for more efficient management of data exchange, design revisions, and interdisciplinary verification activities.
Once the federated model is created, the MEP coordinator initiates the review and clash detection activities. Through dedicated software, it is possible to automatically identify interferences between system elements and those that are architectural or structural. The clashes can be of different natures:
- geometric interferences between components;
- overlapping ducts and pipes;
- collisions with beams, columns, or ceilings;
- accessibility issues for maintenance and installation;
- incompatibilities related to levels or available technical spaces.
- informational inconsistencies between data, classifications, or properties of objects.
However, not all detected interferences have the same importance. For this reason, the MEP coordinator must analyze the results of the clash detection, distinguishing the truly critical conflicts from the so-called “false clashes” (false positives), which are merely apparent or negligible interferences from a construction perspective.
After the analysis phase, the issues are assigned to the respective disciplinary teams for model correction. This process may require several cycles of revision, updating, and verification until a coordinated and validated model is achieved.
In an effective MEP BIM coordination workflow, each interference should be classified by priority, assigned to a responsible person, tracked until resolution, and verified in the updated model. This way, clash detection is not merely an automatic control activity, but becomes part of a structured coordination and project improvement process.
The modern MEP workflow increasingly relies on integrated BIM MEP design approaches, in which designers, systems engineers, and coordinators collaborate from the early stages of design. This approach allows for anticipating many technical decisions and significantly improving the overall quality of the project.
An important role is also played by openBIM standards and interoperable formats like IFC, which facilitate the exchange of models between different software platforms without loss of information. In this way, MEP coordination can be managed in shared collaborative environments, ensuring greater transparency and continuity of information throughout the entire lifecycle of the project.
MEP coordination drawings for multidisciplinary control of the model
MEP coordination drawings (mechanical, electrical, plumbing) are the set of documents that describe the design choices and allow for a comprehensive overview of the work to be done, before its actual construction. They describe the types of systems chosen, their position, sizing, intervention costs, etc.
The main purpose is to reconstruct a general idea of the proposed choices to verify potential interferences between the models:
- mechanical, such as HVAC equipment, cooling towers, and ducts;
- electrical, including panels, elevators, electrical boards, cable trays, transformers, etc.;
- plumbing, like water tanks, drainage wells, pumps, pipes, and drains;
- fire safety and security.

MEP Drawings | plan views, cross-sections and 3D views
This coordination process facilitates the construction phase of the work and the installation of systems, in compliance with the standards set out in the project, the timelines, and the projected costs.
The advantages of coordination drawings are:
- integrated design (multidisciplinary information is presented in a single model);
- resource savings;
- reduction of construction costs;
- reduction of errors caused by incorrect communications;
- improved collaboration and visualization;
- optimization of space;
- identification of clashes at the preliminary stage.
Coordination drawings can be detailed based on the project’s objectives and development phase. Typically, MEP BIM models are developed according to 5 levels of detail:
- 3D MEP preliminary design model (LOD 100);
- 3D MEP detailed design model (LOD 200);
- 3D MEP construction design model (LOD 300);
- MEP construction model (LOD 350);
- MEP prefabrication model (LOD 400).
In the latest BIM processes, the level of geometric detail should be read together with the required information level, according to the concept of LOIN. This allows defining not only how much to model but also what data to associate with MEP objects based on the informational uses of the model.
For further exploration of the levels of detail, I recommend reading the article “LOD and LOIN in BIM: what they are and what they are for.”

Evolution of the MEP model at different LOD levels
Checklist to Avoid Conflicts Between Technological Systems
In MEP coordination, preventing interferences is much more effective than resolving them during the execution phase. Even small modeling errors or lack of coordination between disciplines can indeed generate delays, variations, and additional costs on-site.
For this reason, it is useful to adopt an operational checklist that allows for systematic verification of the compatibility between systems, structures, and architectural elements right from the early stages of the BIM project.
Here are some fundamental checks to perform during the MEP coordination process.
Check Available Technical Spaces
One of the most frequent problems concerns the lack of space for the passage of ducts, pipes, and system networks. It is therefore important to check from the beginning:
- useful heights in the false ceilings;
- dimensions of technical shafts;
- spaces for vertical and horizontal crossings;
- minimum distances between systems.
- access spaces for installation, inspection, and maintenance.
Check for Interferences with Structural Elements
Pipes and ducts must not interfere with beams, columns, walls, or structural floors. Through BIM clash detection, it is possible to quickly identify any collisions and correct the system layout before the construction phase.
Particular attention should be paid to holes in the floors and structural crossings, which must be planned and coordinated with the structural design.
Coordinate the Altimetric Quotas of the Systems
Proper coordination of quotas prevents overlaps between different system systems. Generally, it is useful to define a clear hierarchy for the arrangement of systems in false ceilings and technical rooms.
For example:
- larger HVAC ducts;
- electrical walkways;
- fire networks;
- plumbing and drainage pipes.
Ensure Accessibility for Maintenance and Inspections
A well-coordinated system must also be easily accessible over time. It is therefore necessary to verify:
- spaces for opening technical panels;
- accessibility to valves and panels;
- maintenance areas for HVAC units;
- safe pathways for operators.
- minimum clearances for component replacement, disassembly, and maintenance.
Use Shared Modeling Standards
To avoid coordination errors, it is essential that all teams adopt common criteria for:
- naming of objects;
- classification of elements;
- levels of detail and information, LOD and LOIN;
- revision management;
- IFC export rules;
- coding of issues and responsibilities.
Verify the Correct Interoperability of Models
In openBIM workflows, models are often developed with different software. For this reason, it is important to periodically check the correct export and federation of IFC files, avoiding data loss or compatibility issues.
Constantly Update the Federated Model
MEP coordination is a dynamic process. Every design change must be quickly integrated into the federated model to avoid misalignments between disciplines.
Unsynchronized updates can indeed generate unforeseen clashes, document inconsistencies, and issues during the execution phase.

Fundamental controls in MEP coordination
Types of clashes in MEP coordination
In the MEP coordination process, not all interferences are the same. Correctly classifying them helps the MEP coordinator establish priorities, responsibilities, and resolution methods.
| Type of interference | Example |
| Geometric interference | A pipe crosses a structural beam |
| Spatial interference | The ducts do not respect the available space in the ceiling |
| Functional interference | A valve is not accessible for maintenance |
| Informational interference | A MEP object has missing, inconsistent, or non-compliant information data |
| False positive | The software reports a clash that does not represent a real construction issue |
How coordinated MEP models reduce errors on the construction site
One of the main advantages of MEP coordination in a BIM environment is the ability to identify and resolve many critical issues before the start of work on the construction site. Thanks to the coordinated models, designers, contractors, and installers can work on shared, updated, and consistent information across all involved disciplines.
In traditional methods, many interferences between systems, structures, and architectural elements only emerge during the execution phase, when the possibilities for intervention become more limited and costly. In contrast, a coordinated MEP model allows for anticipating problems already in the design phase, improving control of the entire construction process.
Thus, one of the most obvious benefits is the reduction of rework on site. Identifying clashes between ducts, pipes, walkways, or structural components in advance avoids demolitions, sudden relocations of systems, and last-minute modifications.
The management of variants is also more efficient. A coordinated BIM model allows for quickly assessing the impact of design changes and updating all disciplines in a synchronized manner, reducing the risk of document errors or inconsistencies between deliverables.
An additional advantage concerns the planning of installation activities. The availability of coordinated three-dimensional models indeed facilitates:
- the scheduling of assembly phases;
- the control of operational sequences;
- the prefabrication of system components;
- the management of construction site spaces;
- the coordination among operational teams.
This approach contributes to improving not only the execution quality but also the safety and organization of the work processes.
Coordinated MEP models also promote more effective communication among all actors involved in the project. Through BIM collaborative platforms and data sharing environments, designers, coordinators, and contractors can access real-time updated information, reducing misunderstandings and decision delays.
In particularly complex projects, digital coordination also allows for optimizing technical spaces and improving future management of the building, facilitating maintenance, inspections, and interventions on systems throughout the lifecycle of the work.
| Traditional method | BIM MEP |
| Clashes detected on site | Clashes detected in the design phase |
| Fragmented communication | Shared model |
| Frequent variations | Reduction of rework |
| Separate documentation | Federated model |
| Longer coordination times | Collaborative workflow |
Common problems in MEP coordination
Even with the use of BIM and clash detection software, MEP coordination can present various challenges, especially in projects characterized by high complexity in systems and the presence of multidisciplinary teams.
One of the most frequent problems concerns the lack of coordination among disciplinary models. Models developed with different levels of detail or updated at different times can indeed generate interferences, informational inconsistencies, and difficulties in managing the federated model.
Communication between designers, coordinators, and contractors is also a critical aspect. Without shared workflows and well-defined collaborative procedures, the risk of errors and unsynchronized modifications significantly increases.
Among the most common issues in MEP coordination are:
- collisions between systems and structures;
- insufficient technical spaces;
- false positives generated by the software;
- export errors and interoperability issues between BIM platforms;
- incomplete or outdated models;
- lack of shared modeling standards;
- unclear informational requirements;
- issues not assigned or not properly tracked.
To reduce these criticalities, it is important to define from the beginning shared modeling rules, clear responsibilities, review procedures, and criteria for model validation. This way, MEP coordination is not limited to checking for interferences, but becomes a true integrated quality management activity in design.
Today, MEP coordination represents one of the most important activities in BIM processes, especially in projects characterized by high complexity in systems and strong multidisciplinary integration. Through coordinated models, collaborative workflows, and clash detection tools, it is possible to improve design quality, reduce errors on site, and optimize time and costs of realization.
To effectively manage federated models, information flows, and collaboration among disciplines, it is essential to adopt integrated BIM platforms capable of supporting all phases of the process. BIM management tools and data sharing environments allow for the digital management of constructions and infrastructures in a simple, secure, and collaborative way, improving the control of models, information, and coordination activities.
FAQ – MEP coordination
What is meant by MEP systems?
MEP systems include all mechanical, electrical, and plumbing systems necessary for the operation of a building. The acronym comes from Mechanical, Electrical and Plumbing and includes components such as HVAC systems, electrical networks, lighting, plumbing systems, fire protection systems, and power distribution.
What is MEP coordination?
MEP coordination is the process of coordinating mechanical, electrical, and plumbing systems within a federated BIM model. It serves to identify clashes, verify technical spaces, and reduce design and execution errors.
What is the role of a MEP coordinator?
The MEP coordinator verifies the correct integration of system models with architectural and structural models, identifies clashes, assigns critical issues to the relevant teams, and supports problem resolution before the construction phase.
What is the difference between BIM coordination and MEP coordination?
BIM coordination involves the overall coordination of disciplinary models within the BIM process. MEP coordination, on the other hand, focuses on mechanical, electrical, and plumbing systems and their integration with architecture and structures.
What is a coordinated MEP model?
A coordinated MEP model is a verified system model in relation to other disciplinary models, free from critical clashes, and consistent with the informational, geometric, and functional requirements of the project.
How does clash detection reduce mistakes on site?
Clash detection allows for the identification of collisions and inconsistencies between elements of the model before work begins. This way, problems can be corrected during the design phase, avoiding rework, delays, and changes on site.
